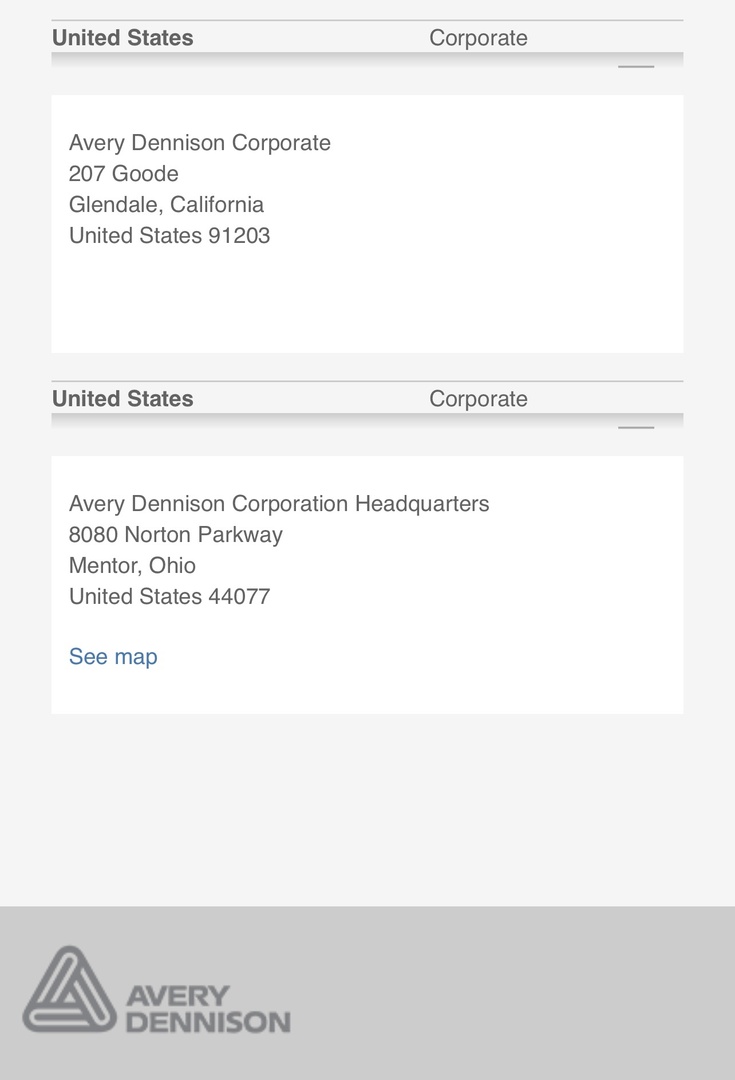

From their website… clearly differentiates between a corporate office in Glendale, and the corporate HQ in mentor.
-
Cleveland: Random Development and News
Wow, just saw that, too. That adds another Fortune 500 HQ to the region. Wonder why it’s received zero press? A recent google search has a lot of results that still list Glendale, CA as the HQ… so I’m thinking the move is recent. Their website clearly lists Mentor as the corporate HQ, though.
-
Canton: Pro Football Hall of Fame Village
Because they, like most investors, don’t see the viability in the concept.
-
Cleveland: Detroit-Shoreway / Gordon Square Arts District: Development News
Geis is the architect and builder. Sixmo is the engineer.
-
Cleveland: Downtown: Sherwin-Williams Headquarters
Concrete structures can typically flip floors in 4-7 days, but there’s substantial shoring that takes place until the concrete is cured to support the structure above it; That is the schedule killer compared to steel. One thing to look out for is how fast the concrete cores rise, because that is a schedule driver for steel structures. I would imagine a week of framing per floor (assuming the cores get a head start of 7-10 floors), but then there’s detailing and the slab on metal deck. No shoring below, so you’ll start to see exterior wall and interior layout happen much sooner than a concrete building.
-
Cleveland: Downtown: Justice Center Complex Replacement
A building is most definitely not just a building. Please explain to me how they are constructed the same way?I I would assume a courthouse has longer structural spans to accommodate large courtrooms. Longer structural spans mean bigger impact to web depth and/or trusses, further impacting column size and foundations. Large courtrooms mean higher floor-to-floor height, which means means more exterior wall. I could go on and on… i would expect something like SHW to be in the $300/SF-$350/SF range, whereas an urban courthouse I would expect to be in the mid $500/SF upwards of $700/SF (construction costs, not total project). Not triple the cost but being double is not out of the realm of possibility.
-
